Serving Greater Bellflower

Automatic Gate Installation

Automatic gate operators supplied and installed across Bellflower, sized to the actual leaf weight and wired to UL 325 monitored safety devices.

Bellflower Metal Gates installs automatic gate operators across Bellflower, California, serving surrounding cities including La Mirada, Cypress, Buena Park, Pico Rivera and Stanton. We automate swing, slide, cantilever and bi-fold gates, both gates we have fabricated ourselves and existing gates installed by others, and we supply and service LiftMaster, DoorKing, HySecurity and FAAC equipment.

An automatic gate is a machine that moves several hundred pounds of steel across a space people and vehicles occupy, and almost everything that goes wrong with one traces back to a specification made from the wrong number. The number most commonly used is the opening width, because it is the easiest to obtain over the phone. The numbers that actually matter are the weight of the leaf, its leverage about the hinge, and how many times a day it will run. An operator chosen from width alone is a coin toss.

We take those measurements before recommending anything. That means establishing the leaf weight, checking whether the gate is square and rigid enough to be driven at all, confirming the footings will take cycling loads rather than only static ones, and asking how the property actually uses the gate. A gate serving eight units is a commercial-duty application even though the building is residential, and specifying it as residential guarantees an early failure.

Choosing and Sizing the Operator

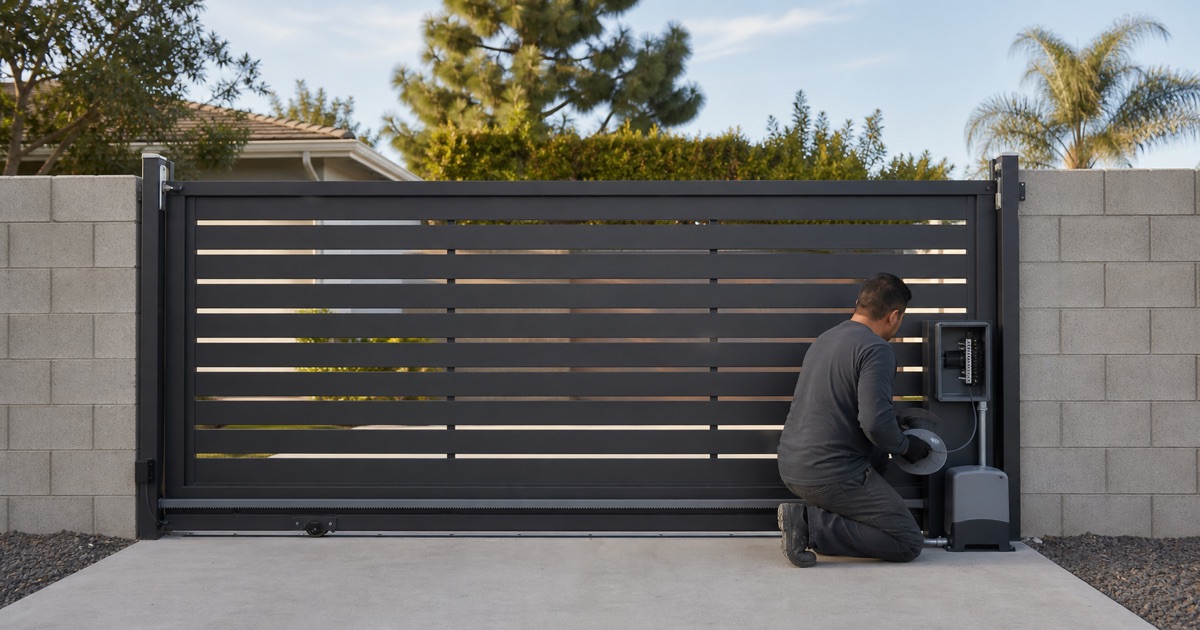

Installer feeding operator cable from a spool into the conduit at a gate operator

Matching the Operator to the Leaf

Every operator carries a rated leaf weight and width, and those ratings assume a gate that is square, freely moving and correctly hung. We measure against them with margin rather than to the limit, because a unit run permanently at the top of its rating has no reserve for a windy day, a stiffening hinge or a gate that has picked up a slight drag. Sizing with headroom costs a little more once and saves the cost of replacing a burnt-out operator and everything downstream of it.

UL 325 Duty Classes

UL 325 classifies operators by application: Class I for single-family residential, Class II for multi-family and commercial with general access, Class III for commercial and industrial with limited access, and Class IV for restricted-access sites with trained supervision. The class is not a marketing tier, it describes the duty the unit is built to withstand. We select the class from how the gate is genuinely used rather than from the type of building it happens to stand in front of.

Swing, Slide and Cantilever Operators

The mechanism follows the gate type. Swing gates take arm or articulated-arm operators, or underground units where the installation must be invisible. Slide and cantilever gates take rack-driven or chain-driven operators sized to the leaf length and weight. Each has its own failure mode, and we specify for it: arm operators put concentrated load into the hinge post, while rack-driven units depend on the rack staying properly aligned to the pinion along the whole run.

Solar Operators and Battery Backup

Where a mains supply would mean trenching a long driveway, a solar operator with battery backup is frequently both cheaper and simpler. The specification that matters is not the operator but the panel and battery, sized to the daily cycle count and to the worst realistic run of overcast days rather than to an average. Battery backup is also worth specifying on mains-powered gates, particularly community and commercial installations where an outage otherwise strands vehicles.

Safety, Standards and Compliance

UL 325 Monitored Entrapment Protection

An automatic vehicular gate requires two independent means of entrapment protection, and current operators monitor those devices continuously, refusing to run if one fails or is disconnected. That behaviour is deliberate and it is the single most important safety feature on the machine. We install monitored photo eyes and safety edges to the operator’s monitored inputs, and where a nuisance fault keeps recurring we find and fix its cause rather than bridging the input out to stop the complaint.

ASTM F2200 and the Gate Itself

Most entrapment incidents involve the gate rather than the operator: a gap that closes as the leaf travels, an exposed roller, a picket passing close to a fixed post. ASTM F2200 addresses exactly those construction details, and it applies whether the gate is new or is an existing one being automated. We assess an existing leaf against it before quoting automation and include any screening, guarding or edge protection the standard calls for in the written scope.

Loop Detection and Vehicle Sensing

Inductive loops cut into the driveway do three distinct jobs. An exit loop opens the gate for a vehicle leaving, a safety loop holds it open while a vehicle is beneath it, and a shadow loop prevents closure onto a vehicle stopped in the opening. Gates that close on cars are usually missing the second or third. We saw-cut and seal loops into the surface rather than surface-mounting them, since a proud loop is destroyed by tire traffic within weeks.

Emergency Services Access

A gated driveway that fire apparatus may need to enter requires an approved means of access, normally a Knox box or a fire department key switch wired to the operator, driven by California Fire Code fire apparatus access road requirements. This is agreed with the authority having jurisdiction and designed in from the start. Retrofitting it after an inspection failure costs several times what including it would have, and it is one of the easiest items to settle early.

Our Step-by-Step Automation Process

Assess the Gate and the Opening

We check the leaf for square and rigidity, the hinges and footings for wear and movement, the driveway for slope and crown, and the site for available power. Where the gate needs work before it can be driven, that comes first and is priced separately.

Specify and Approve

You get the operator selection, its UL 325 class, the safety devices and the access hardware in a written proposal before anything is ordered, along with what we found on the existing gate. Anything we identified but were not asked to address is listed separately, so nothing on that list proceeds without your agreement.

Install, Wire and Commission

Conduit and cabling go in, the operator is mounted and aligned, safety devices are installed to the monitored inputs, and loops are cut and sealed. The gate is then run through its full travel under load with every safety device tested rather than assumed working.

Handover and Follow-Up

You receive a written handover covering opener programming, remote pairing and the manual release. We return once the gate has settled to re-level hinges and re-tension hardware, because a newly automated gate beds in over its first weeks.

  • Licensed & Insured
  • Free On-Site Estimates
  • 20+ Years in Bellflower

Good to know

Frequently Asked Questions

How do you decide which operator my gate needs?

From the leaf, not the opening. We weigh or calculate the leaf, measure its width, and establish how many cycles it will run in a typical day, then select an operator whose duty rating covers that with margin. We also match the UL 325 class to the application, since a Class I residential unit and a Class III commercial unit are built to different expectations. Width alone is the number most quotes use and it is not sufficient.

Can my existing gate be automated?

Usually, once it has been assessed. The leaf has to be square and rigid, the hinges and footings sound, and the construction has to meet ASTM F2200, which addresses pinch and shear points a hand-operated gate never had to consider. Where the leaf has sagged we rebuild the hinge stile or add a diagonal brace first, because fitting a motor to a gate that already drags simply transfers the resistance into the operator.

What safety equipment is legally required?

UL 325 requires two independent means of entrapment protection on an automatic vehicular gate, and modern operators monitor those devices and refuse to run if one is faulted or disconnected. In practice that usually means photo eyes plus a safety edge, often supplemented by inductive loops. The gate itself must also be built to ASTM F2200. We install the devices to the operator's monitored inputs rather than bridging them out.

Is a solar gate operator a real option or a compromise?

It is a genuine option when it is sized properly. The panel and battery have to be matched to the daily cycle count rather than to the operator's badge rating, because a gate cycling forty times a day stores and spends far more energy than one cycling six. Undersized solar is the reason these systems get a poor reputation. Where a mains run would mean trenching a long driveway, correctly sized solar is usually cheaper and just as reliable.

How long does an automatic gate installation take on site?

The gate and posts are typically a day or two once fabrication is complete, with automation adding time for conduit, power and commissioning. What sets the overall schedule is not site time but the stages before it: the measure, the dimensioned drawing you approve, and fabrication. We give a schedule with the written proposal rather than a general estimate, because operator availability and finish both move it.

What happens if the power goes out?

Every operator has a manual release that disengages the drive so the leaf can be moved by hand, and its location and operation are covered in the written handover rather than left for you to find. Operators specified with battery backup will continue to cycle through an outage for a period set by battery capacity. On community and commercial gates we generally treat backup as standard rather than optional.

Do I need a permit to automate a gate in Bellflower?

Automation itself is not what triggers the zoning question; height is. Under section 17.72.060(D) anything over six feet, and anything above 42 inches in the front area, requires Planning Director approval. Electrical work to supply the operator is a separate consideration. We establish at design stage what your specific installation requires so it is settled before fabrication rather than at inspection.

How often does an automatic gate need servicing?

It depends almost entirely on cycle count, which is why we ask about it at specification. A residential gate cycling a handful of times a day needs little beyond periodic hinge greasing and a safety device check. A commercial gate running continuously wears rollers, chain and hinge pins on a predictable schedule, and servicing those before they fail is considerably cheaper than the emergency call when they do.
